10 MW Solar Power Plant Cost in India: 2026 EPC Guide

A 10 MW solar power plant can generate more than 1.4 crore units of clean electricity every year, enough to power a large industrial cluster, a group of factories, or a mid-sized town almost entirely on sunlight. If you are an industrial group, a landowner, or a developer trying to pin down the real 10 MW solar system price in India before approaching EPC contractors, this guide gives you the full picture. In 2026, a 10 MW solar power plant sits firmly in utility and independent power producer territory, with its own cost structure, land planning, financing routes and incentive rules that differ significantly from smaller commercial rooftop or MW-scale projects. Below, we break down the complete 10 MW solar power plant cost, land requirement, real generation numbers, subsidy and tax rules, and a practical profit and ROI picture for 2026.

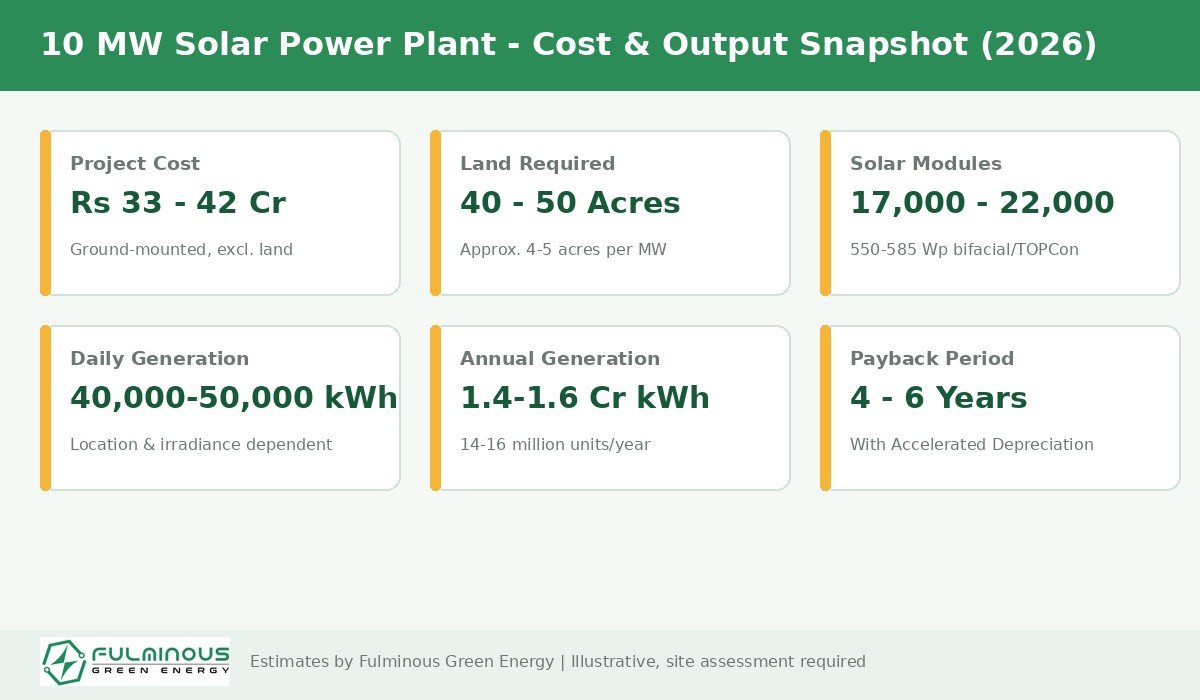

10 MW solar power plant cost, land and generation snapshot 2026
Quick snapshot: 10 MW solar power plant cost, land requirement and output for 2026

What Is a 10 MW Solar Power Plant, and Who Builds One?

A 10 MW (10,000 kW) solar power plant is a full utility-scale solar farm, generating roughly 40,000 to 50,000 units of electricity a day. This is a different category of project altogether from rooftop or small ground-mounted commercial solar: it typically involves dedicated land acquisition, a formal power evacuation plan, and either a captive, group captive, or Power Purchase Agreement (PPA) structure to monetise the generated electricity.

Almost Always Ground-Mounted, Rarely Rooftop

Unlike smaller commercial capacities that can sometimes fit on a large industrial roof, a 10 MW solar power plant is built as a ground-mounted solar farm in virtually every case, requiring 40 to 50 acres of contiguous, shadow-free land. Floating solar on large reservoirs or industrial water bodies is occasionally used at this scale where land is scarce, though it adds cost and technical complexity compared with a conventional ground-mounted layout.

Typical Developers and Buyers of a 10 MW Solar Plant

The most common builders of a 10 MW solar power plant in India include large industrial groups consolidating power needs across multiple facilities, independent power producers (IPPs) developing the project to sell electricity under a long-term PPA, group captive consortiums where several mid-sized businesses jointly own the plant, and landowners partnering with an EPC or IPP to monetise large landholdings. With commercial and industrial power tariffs running between ₹8 and ₹12 per unit in several states, a 10 MW solar power plant offers strong economics against a levelised solar generation cost that is typically under ₹4 per unit.

10 MW Solar Power Plant Cost in India: Full 2026 Price Breakdown

Based on current 2026 EPC benchmarks for utility-scale ground-mounted solar projects, the 10 MW solar power plant cost in India typically falls between ₹33 crore and ₹42 crore, excluding land acquisition. This works out to roughly ₹3.3 crore to ₹4.2 crore per MW, reflecting the economies of scale that larger projects unlock compared with 1 MW or 2 MW installations. The exact 10 MW solar system price you are quoted depends on module technology, mounting structure, grid evacuation voltage level, and whether your project falls under DCR (Domestic Content Requirement) sourcing rules.

What Determines Your Final 10 MW Solar System Price

  • Module technology: N-type TOPCon and bifacial modules cost more per watt than mono-PERC panels but deliver higher energy yield and slower long-term degradation, which matters more on a project this size over 25 years.
  • Mounting structure: Fixed-tilt structures remain the most economical at this scale; single-axis trackers raise upfront cost by 12 to 18% but can lift annual generation by 10 to 20%.
  • Grid evacuation voltage and distance: A 10 MW plant typically needs a dedicated 33kV or higher evacuation line and substation bay, and the further the site is from the nearest grid infrastructure, the higher this cost climbs.
  • DCR vs Non-DCR modules: Projects tied to government schemes or DISCOM procurement that mandate Domestic Content Requirement panels can see total budgets shift by several crore compared with non-DCR sourcing.
  • ALMM compliance: Since June 2026, all commercial and utility solar projects must use MNRE ALMM List-II modules; non-compliant modules risk losing grid connectivity or PPA approval entirely.
  • EPC scope and financing structure: A full turnkey EPC contract with performance guarantees costs more than a supply-only order, and CAPEX ownership carries different financing costs than an OPEX or third-party PPA model.

10 MW vs Other Solar Plant Capacities: Cost Comparison

Plant CapacityApprox. Cost (2026)Land RequiredDaily GenerationApprox. Modules Needed
3 MW₹10.5 – 14 Crore12 – 15 Acres12,000 – 15,000 kWh5,000 – 6,500
5 MW₹17 – 22 Crore20 – 25 Acres20,000 – 25,000 kWh8,500 – 11,000
10 MW₹33 – 42 Crore40 – 50 Acres40,000 – 50,000 kWh17,000 – 22,000
20 MW₹65 – 82 Crore80 – 100 Acres80,000 – 100,000 kWh34,000 – 44,000

These figures are indicative EPC benchmarks for 2026 and can shift with module price movements, evacuation infrastructure and site-specific conditions. If 10 MW is larger than your current requirement, our guide on 3 MW solar power plant cost covers the mid-scale tier in detail, while our broader overview of commercial solar installation cost in India is useful if you are still narrowing down the right capacity for your business.

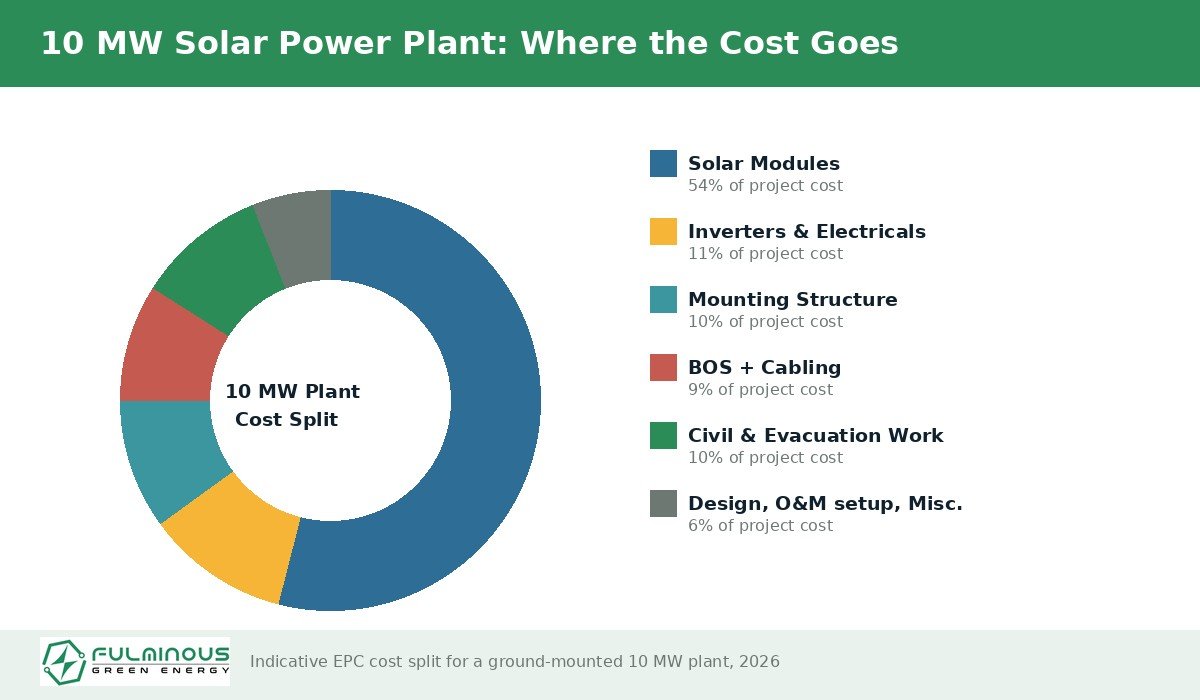

10 MW solar plant cost breakdown by component 2026
Where the money goes: indicative cost split for a 10 MW solar power plant

Evaluating land or an EPC quote for a 10 MW project? Fulminous Green Energy can prepare a free feasibility estimate and evacuation assessment for your 10 MW solar plant. Talk to our utility-scale solar team.

How Much Land Is Required for a 10 Megawatt Solar Plant?

A 10 MW solar power plant typically requires 40 to 50 acres of land, roughly 4 to 5 acres per MW, depending on module efficiency, row spacing and site layout. This is one of the largest single planning variables in the entire project, since land availability, title clarity, and proximity to grid infrastructure directly shape both cost and project timeline.

Land Planning for a 10 MW Ground-Mounted Plant

Row spacing at this scale is calculated to prevent one row of panels from shading the row behind it at the site’s lowest winter sun angle, and the same principle that applies to smaller plants simply scales up across a much larger footprint. Beyond the panel area itself, a 10 MW plant needs space for a substation and switchyard, internal access roads for maintenance vehicles, a control room, security infrastructure, and a boundary buffer. Land located far from the nearest 33kV or higher substation may look cheaper on paper but can add substantially to cabling and evacuation infrastructure costs, so proximity to the grid should be weighed alongside the raw land price per acre.

Title, Diversion and Clearances

At 40 to 50 acres, land title verification, conversion of agricultural land to non-agricultural use where required, and environmental or forest clearances (if applicable) become significant workstreams in their own right. Developers should budget realistic time, typically several months, for these approvals to run in parallel with technical design and procurement, rather than treating them as a formality to be resolved after financial closure.

10 MW Solar Plant Power Generation: Daily, Monthly and Annual Output

A well-designed 10 MW solar power plant in India generates approximately 40,000 to 50,000 units (kWh) of electricity per day, adding up to roughly 1.4 to 1.6 crore units (14 to 16 million kWh) per year in high-irradiance states such as Rajasthan, Gujarat, Madhya Pradesh and parts of Maharashtra and Karnataka. States with longer monsoon seasons or lower average solar irradiance will typically see generation at the lower end of this range.

What Affects Your Generation Numbers at Utility Scale

The real-world output of a 10 MW solar plant depends on local solar irradiance, module technology and its temperature coefficient, the tilt and orientation of the mounting structure, and ongoing maintenance quality across a much larger array than smaller projects. At this scale, even a small percentage loss from soiling, string faults or inverter downtime translates into a meaningful drop in annual revenue, which is why SCADA-based monitoring and a disciplined operations and maintenance schedule matter enormously. Our approach to solar system maintenance is built to protect these generation numbers across the plant’s full 25-year operating life.

10 MW Solar Plant Profit and ROI: Real Numbers for 2026

The profitability of a 10 MW solar power plant depends heavily on how the electricity is used or sold. At this scale, businesses and developers in 2026 typically choose one of the following structures.

Revenue and Savings Models: Captive, Group Captive and PPA

  • Captive consumption: A large industrial group builds the plant to power its own facilities, offsetting grid purchases at ₹8 to ₹12 per unit with solar generation costing roughly ₹3 to ₹4 per unit.
  • Group captive: Multiple mid-sized businesses jointly own the plant, each holding at least 26% equity per current group captive rules, and consume the power through open access, sharing the savings proportionally.
  • Power Purchase Agreement (PPA): An independent power producer builds and owns the 10 MW solar plant and sells the electricity to a DISCOM or commercial buyer under a 10 to 25 year PPA at a pre-agreed per-unit tariff, which is typically lower than captive tariffs but backed by long-term contracted revenue.

Worked ROI Example

Take a 10 MW solar plant built for ₹38 crore, generating 1.5 crore units a year and used for captive or group captive consumption against a blended grid tariff of ₹8.5 per unit. The annual saving works out to roughly ₹12.5 crore to ₹13 crore. Even before applying tax benefits, this points to a simple payback of about 3 years, and most developers report an internal rate of return (IRR) in the 12 to 18% range across the plant’s operating life, with full payback typically achieved within 4 to 6 years once financing costs and seasonal generation variation are factored in. PPA-based projects selling to a DISCOM at a lower, contracted tariff will see a longer payback, often 6 to 8 years, offset by lower revenue risk over the contract term. To model your own numbers against your actual tariff and consumption structure, try our solar ROI calculator before finalising your project size.

Want a realistic payback estimate for your project? Share your land details, evacuation point and intended offtake model with Fulminous Green Energy, and we will map out a custom ROI projection for your 10 MW solar plant. Request your free ROI report.

Government Subsidies, Tax Benefits and Incentives for 10 MW Solar Projects (2026)

Direct capital subsidy schemes such as PM Surya Ghar apply only to residential rooftop solar and have no bearing on a 10 MW utility-scale project. At this capacity, PM-KUSUM is also not applicable, since Component-A of that scheme is capped at individual plant sizes between 500 kW and 2 MW. Instead, the financial case for a 10 MW solar power plant in 2026 rests on tax depreciation benefits, state solar park infrastructure support, and open access policies.

Accelerated Depreciation Under Section 32

Businesses that own a 10 MW solar plant as a business asset can claim Accelerated Depreciation (AD) under Section 32 of the Income Tax Act, 1961. Solar power generating assets qualify for a 40% depreciation rate in the first year on the written-down value (WDV) method, provided the plant is commissioned and generating power for more than 180 days in that financial year. On a ₹38 crore plant, this can translate into a first-year depreciation deduction of roughly ₹15.2 crore, substantially improving cash flow during the early payback period. Businesses should keep the DISCOM commissioning certificate, fixed asset register entries and a CA-certified Form 3CD ready to support this claim, and should confirm eligibility with a qualified chartered accountant before finalising their capital structure.

Solar Park Scheme and Open Access Support

Developers building within a government-designated cluster can benefit considerably from the commercial solar park scheme, which typically provides pre-developed land, shared evacuation infrastructure and simplified approvals, reducing both cost and project timeline compared with an independently sourced site. Several states also offer electricity duty exemptions, banking facilities and cross-subsidy surcharge waivers for open-access solar projects, though the specific rules and their applicability vary considerably by state and change periodically. Our reference on state-level rooftop solar subsidies is a useful starting point even at this scale, since many of the underlying open-access and net-metering principles overlap with the rules governing larger projects. For readers exploring smaller individual capacities alongside a larger plant, our guide to the PM-KUSUM scheme explains where that scheme’s 500 kW to 2 MW eligibility window applies instead.

10 MW Solar EPC Process: Step-by-Step 2026 Guide

Executing a 10 MW solar power plant project well requires a disciplined EPC (Engineering, Procurement and Construction) process, with considerably more coordination than smaller commercial installations.

  1. Feasibility study and land finalisation: Site survey, shadow analysis, soil testing, title verification and land conversion where required, typically 4 to 8 weeks.
  2. Design and engineering: Single-line diagrams, structural design, module and inverter selection, substation and evacuation planning, typically 4 to 6 weeks.
  3. Approvals and grid connectivity: DISCOM or transmission utility feasibility approval, open access or PPA structuring, and statutory and environmental clearances, which can run in parallel with procurement.
  4. Procurement: Sourcing ALMM-listed modules, inverters, mounting structures, transformers and cabling from verified manufacturers, confirming DCR compliance where required.
  5. Civil and electrical installation: Land levelling, foundation work, structure erection, module mounting, cabling, substation and transformer installation, typically 4 to 7 months for a 10 MW plant.
  6. Testing, commissioning and handover: Load testing, DISCOM or transmission utility inspection, commissioning certificate, and SCADA-based monitoring setup, followed by ongoing operations and maintenance.

Most 10 MW solar plants in India are commissioned within 8 to 12 months of financial closure, assuming land, title and approvals are in place before construction begins. Post-commissioning, a structured operations and maintenance plan protects generation performance and Accelerated Depreciation eligibility over the plant’s 25-year life.

10 MW vs Other Solar Plant Sizes: Which Capacity Is Right for You?

Not every business or developer needs exactly 10 MW. The right capacity depends on total electricity consumption across your facilities, available land, financing capacity, and whether you intend to consume the power captively or sell it under a PPA. Businesses with smaller individual loads sometimes aggregate demand across a group captive structure to justify a 10 MW plant, while others build in phases starting at 2 MW or 3 MW before scaling up once the first phase proves out. A 10 MW solar power plant tends to suit large industrial groups, IPPs and landowners with a combined electricity requirement, or a PPA offtake opportunity, in the range of ₹1 crore to ₹1.5 crore in monthly electricity value.

Frequently Asked Questions About 10 MW Solar Power Plant Cost

What is the cost of a 10 MW solar power plant in India in 2026?

A ground-mounted 10 MW solar power plant in India typically costs between ₹33 crore and ₹42 crore in 2026, excluding land. The exact 10 MW solar system price depends on module technology, mounting structure, evacuation infrastructure and EPC scope.

How much land is required for a 10 megawatt solar plant?

A 10 MW solar power plant generally requires 40 to 50 acres of land, roughly 4 to 5 acres per MW. Additional area is needed for the substation, switchyard, internal roads and boundary buffer.

How much profit can a 10 MW solar plant generate every year?

Used for captive or group captive consumption against an ₹8 to ₹12 per unit grid tariff, a 10 MW solar plant can save or earn businesses roughly ₹12.5 crore to ₹13 crore a year, with typical payback in 4 to 6 years and an IRR of 12 to 18% over its operating life. PPA-based projects see lower annual revenue but a longer, more predictable contract term.

Is subsidy available for a 10 MW solar power plant?

Direct capital subsidy schemes such as PM Surya Ghar and PM-KUSUM do not apply at this capacity. A 10 MW plant instead benefits mainly from 40% first-year Accelerated Depreciation under Section 32, plus solar park infrastructure support and state-level open access incentives where applicable.

How long does it take to install a 10 MW solar power plant?

Most 10 MW solar power plants in India are commissioned within 8 to 12 months of financial closure, covering design, procurement, civil and electrical installation, evacuation infrastructure, and DISCOM or transmission utility commissioning, assuming land and approvals are secured in advance.

Conclusion: Is a 10 MW Solar Power Plant Worth It in 2026?

For large industrial groups, independent power producers and landowners with the right site, a 10 MW solar power plant remains one of the strongest long-term energy investments available in 2026. Falling module prices, improved TOPCon and bifacial technology, a well-established 40% Accelerated Depreciation benefit, and rising grid tariffs together push most well-designed 10 MW solar projects toward payback within 4 to 6 years for captive structures, with 20 or more years of low-cost generation left after that. The real work is in getting the fundamentals right: securing clear land title, planning grid evacuation early, choosing ALMM-compliant components, and working with an EPC partner who manages approvals, construction and long-term maintenance under one roof.

Ready to see what a 10 MW solar power plant would cost and deliver at your specific site? Contact Fulminous Green Energy today for a free feasibility study, land and evacuation assessment, and a detailed EPC proposal tailored to your project.

Leave a Comment

Your email address will not be published. Required fields are marked *

Scroll to Top

Areas We Serve Across Rajasthan

Solar panel installation & consultation services available in these districts:
